Buffalo Niagara International Airport Rehabilitate and Reconstruct Runway 5-23

A Uniquely Rigorous Schedule Kept Goals in Sight and on Time
Project Type
Project Owner

Niagara Frontier Transportation Authority (NFTA)

Completion Year

2023

Contract Value

$28,645,030

Project Award

4/26/2022

Project Overview

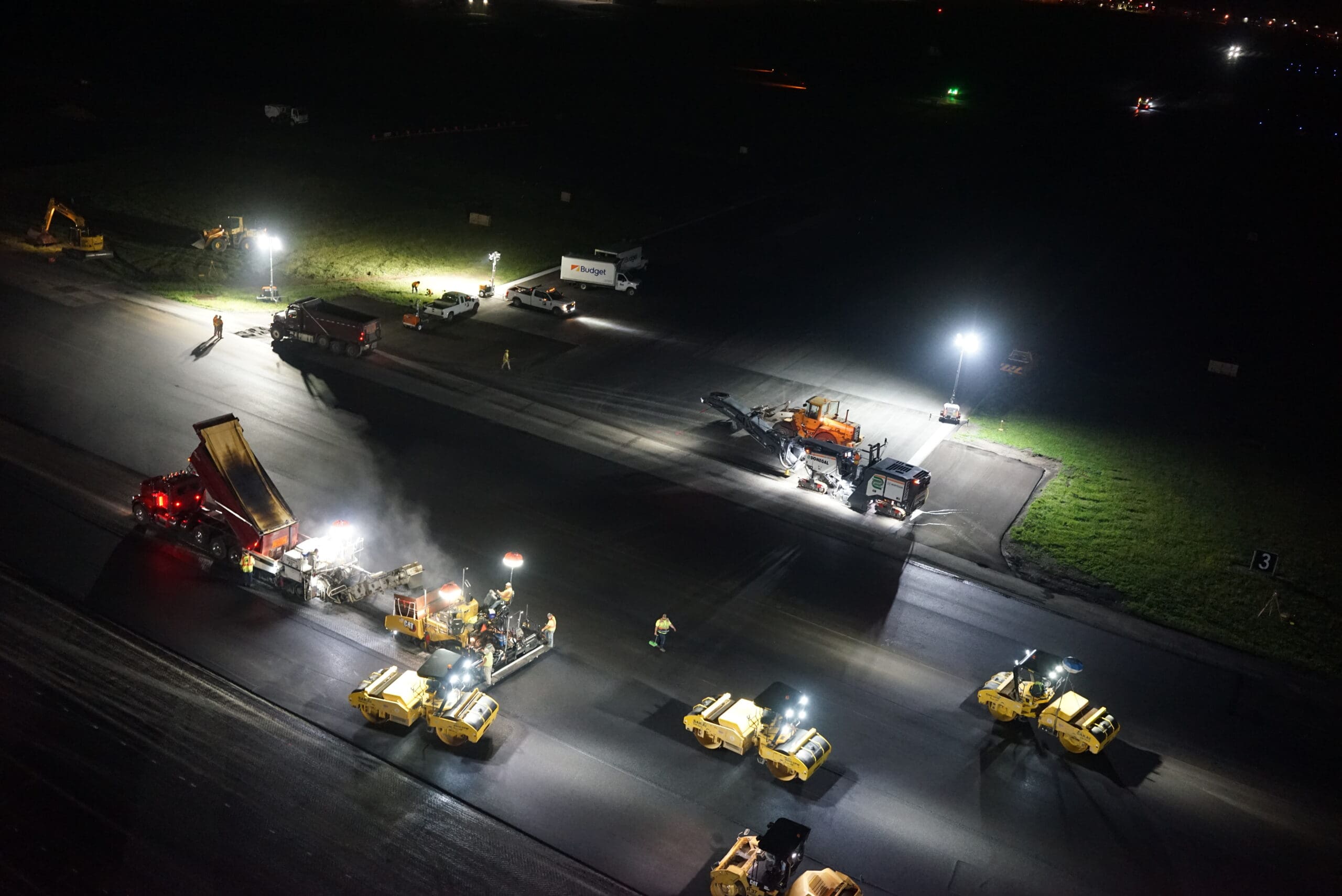

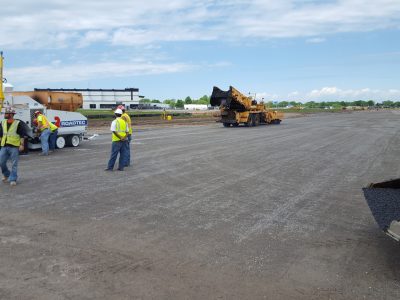

Union Concrete completed an intensive construction schedule in 2023 for the Rehabilitation and Reconstruction of the East side of Runway 5-23, including the intersection for runways 5-23 and 14-32 along with significant electrical work. This was a 4-phase contract stipulating a uniquely rigorous schedule which was developed in 10 minute increments allowing the successful evasion of $25,000/half hour liquidated damages. The work was completed in four of the five scheduled weekend shutdowns while air traffic was temporarily suspended.

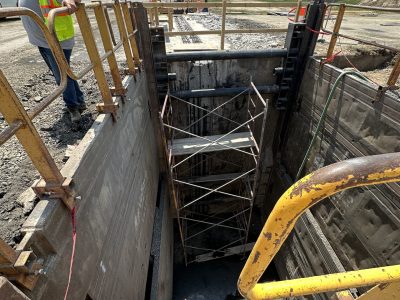

Other airfield maintenance included overlays on Taxiways A, D, C, B and V, full depth reconstruction of Taxiway D, new drainage and other miscellaneous work.  This contract also included non-airfield rehabilitation work on the Perimeter Rd and Aero Dr tunnels.

Project Stats

80,000 Tons of Asphalt

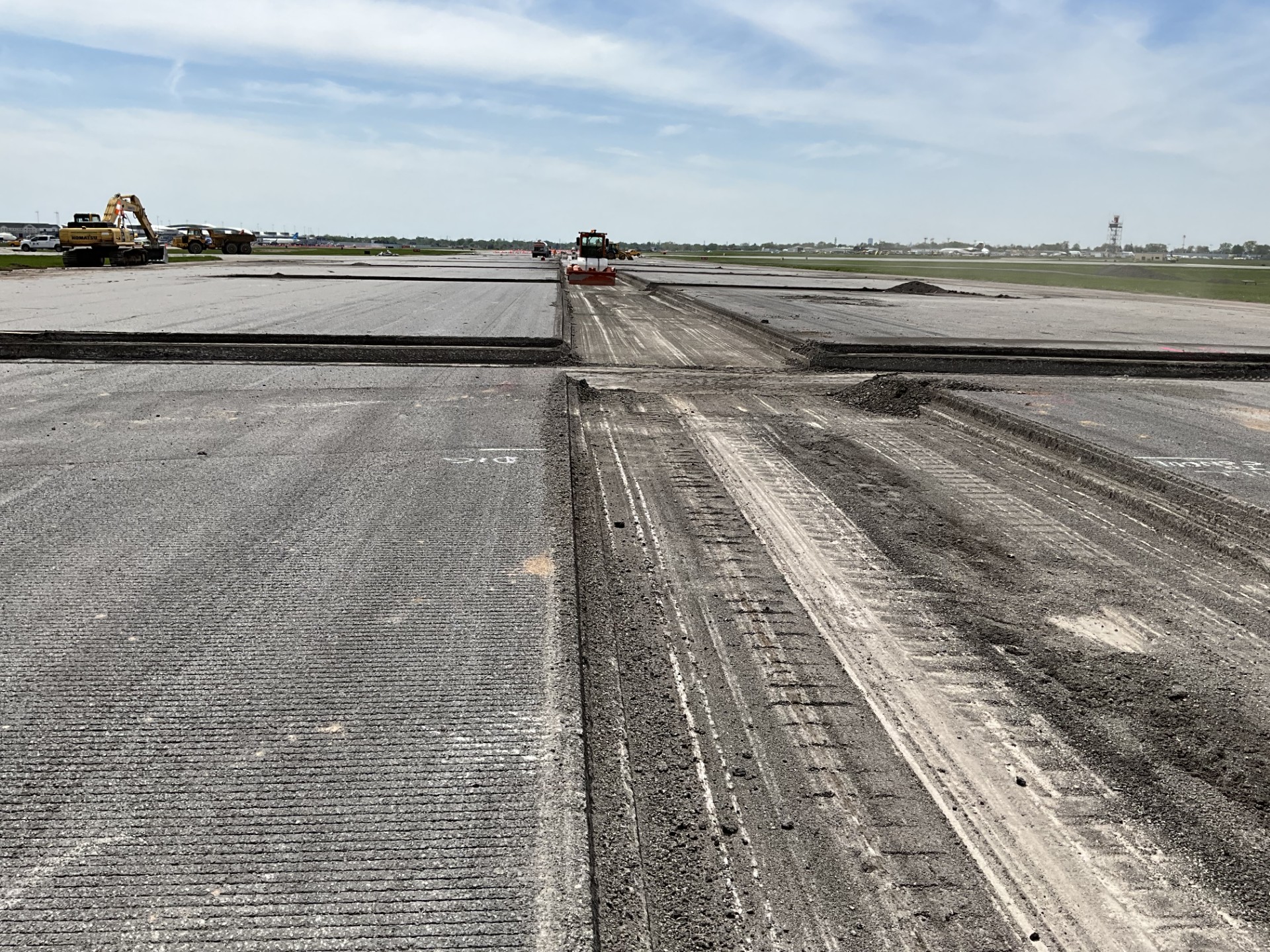

235,000 Sq. Yards of Profile Milling
project highlights

Key project highlights preformed.

It's Electric
Integral electrical work was included to support 180 in-pavement TDZ lights, runway lights, and taxiway edge lights.
Inclement Weather Impacts

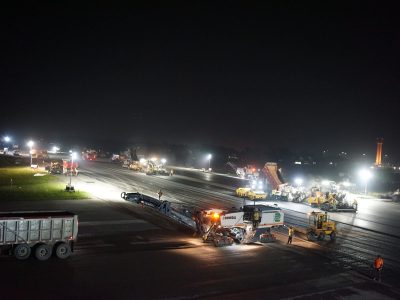

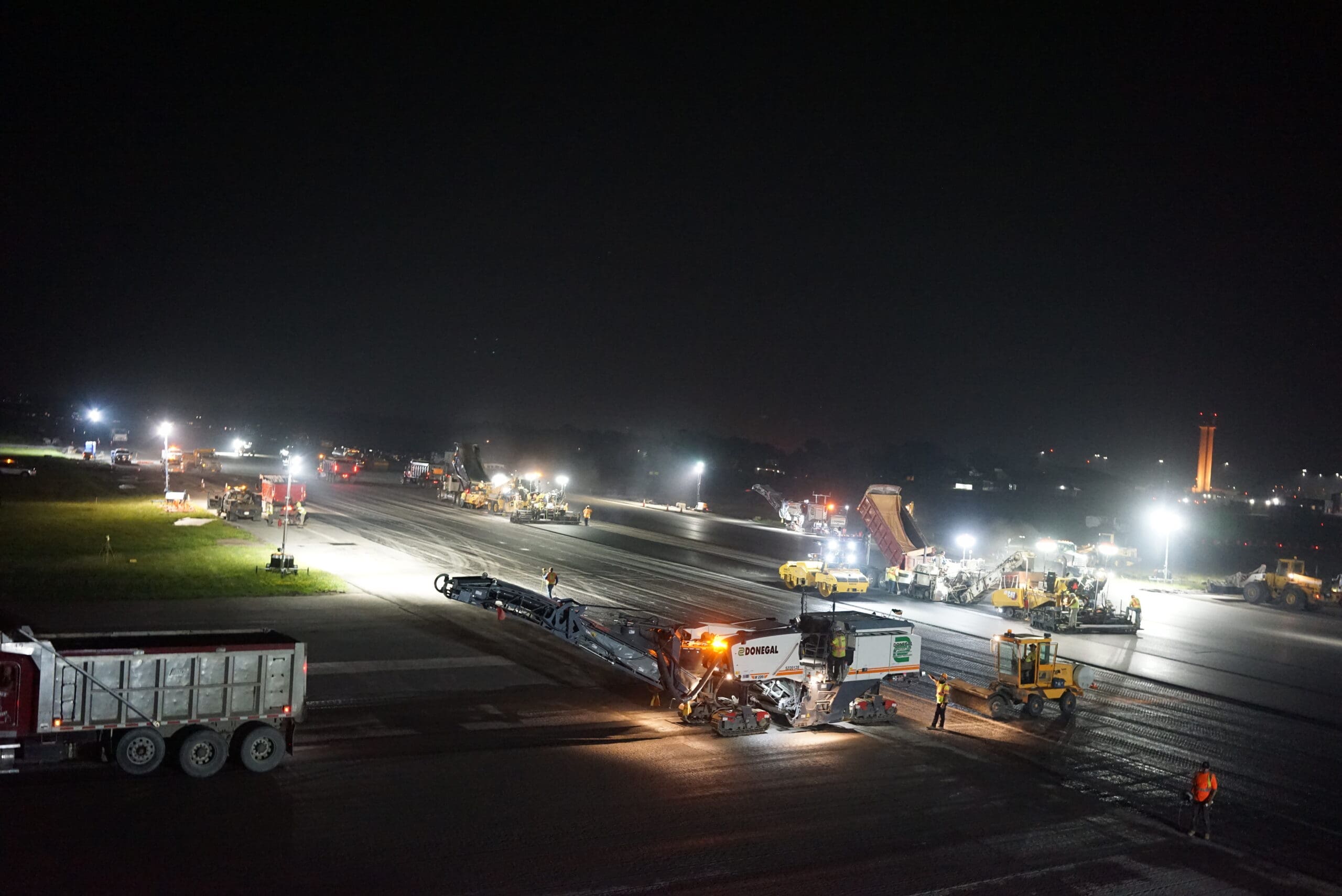

5-23 was bid with a stipulation of five (5) weekends with crews operating 10:45pm – 6:00am to complete work. Crews “lost” one weekend due to inclement weather. However, an additional weekend was not needed and work was completed in a total of four weekends.
Project Awards

Our commitment to quality and excellence recognized.

Key Personnel

Brought to you by...

Senior Project Manager
Sub Projects

This complex project had many different aspects.

Let's get to work.

Lorem ipsum dolor sit amet, consectetur adipiscing elit. Ut elit tellus, luctus nec ullamcorper mattis, pulvinar dapibus leo.
